Parking review phase summary

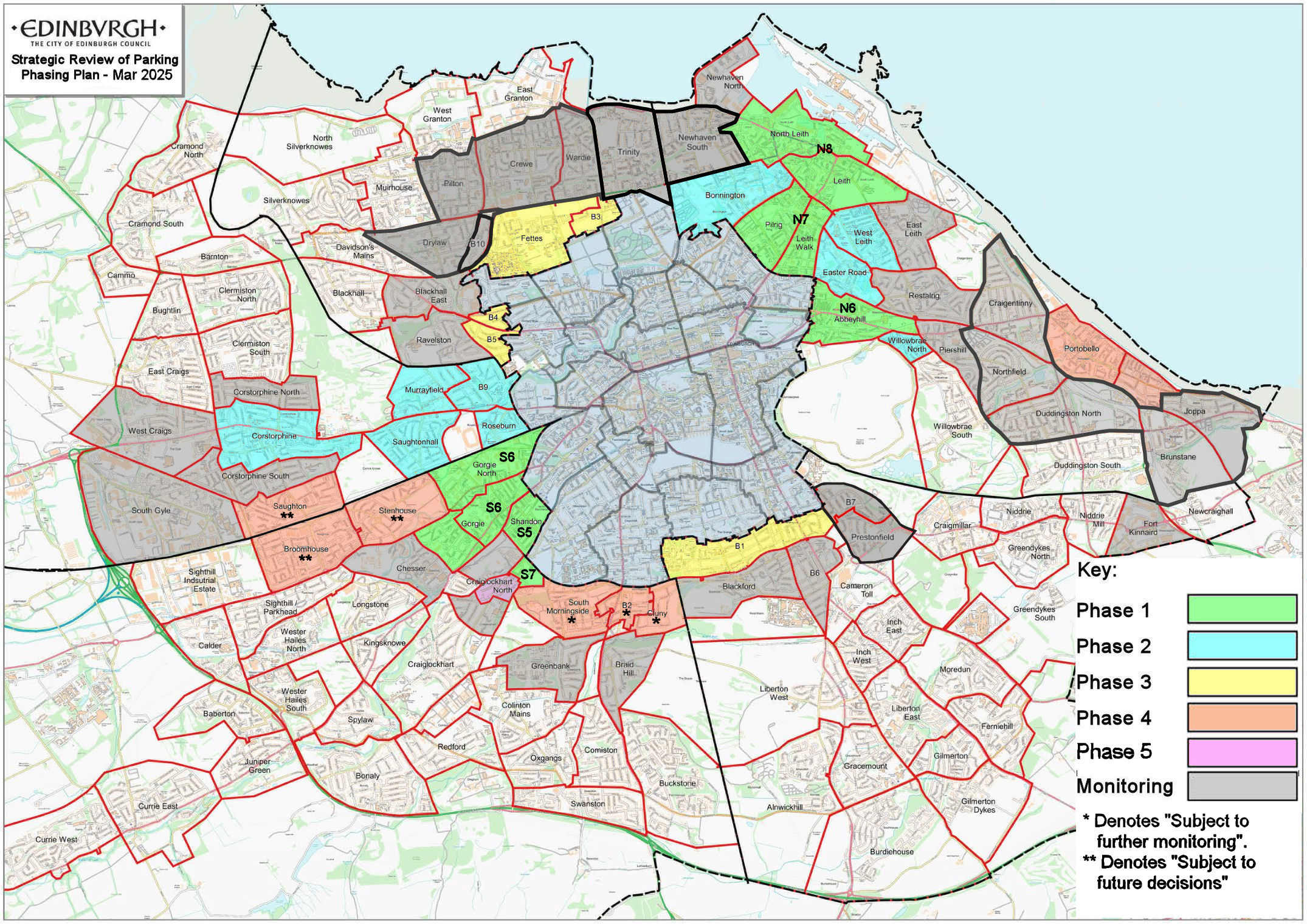

Phase plan
To view the current progress of the strategic review of parking and proposed areas for future parking controls, you can view our phase plan.
Phase 1 - Leith / Abbeyhill and Gorgie / Shandon
Parking controls were implemented across the approved phase 1 areas in 2023 and 2024:
|
Zone |
Go-live date |
|---|---|
|
N6 (Abbeyhill) |
4 September 2023 |
|
N7 (Leith Walk / Pilrig) |
26 June 2023 |
|
N8 (Leith / North Leith) |
26 June 2023 |
|
S5 (Shandon) |
23 October 2023 |
|
S6 (Gorgie) areas 1 and 2 |
20 November 2023 |
|
S7 (B8 priority parking area) |
20 November 2023 |
|
S6 (Gorgie) areas 3 and 4 |
18 November 2024 |
|
S6 (Gorgie) West |
23 March 2026 |
S6 West Controlled Parking Zone
The S6 Controlled Parking Zone was implemented in phases, with only the eastern part of the zone being implemented initially. This approach allowed us to carry out further monitoring in the western part of S6. Since 9 March 2026, eligible residents and businesses have been able to apply for parking permits, with the new parking controls in effect from 23 March 2026.
We will continue to monitor the western part of zone S6 and will review monitoring data and feedback from residents to understand how the zone is working, and whether there are any areas where controls should be reviewed. Monitoring is an important aspect of the implementation of parking controls and ensures that adjustments are made where required, once new controls have bedded in.
Phase 2 - Easter Road, Lochend / Ryehill (called West Leith on our plans), Bonnington, Willowbrae and the A8 Corridor
An informal consultation process took place in February and March 2021 with results being reported to the Transport and Environment Committee in August 2021. At that time, Committee decided that monitoring of the potential impacts of phase 1 and further engagement on the design and detail of phase 2 should be undertaken.
The Council has since completed phase 1 implementation and carried out surveys to gather feedback from residents and businesses. The feedback was reported to Committee, along with the results of monitoring and capacity surveys.
Further monitoring of parking pressures in the phase 2 areas adjacent to the new CPZs, implemented as part of phase 1, was also carried out, to check for any displacement of vehicles. The areas surveyed include Easter Road, Lochend (West Leith), Willowbrae, Bonnington, and Piershill, and the resultant data was reported to Committee in November 2025.
We are now developing proposals for some phase 2 areas. We will not formally advertise the proposals prior to holding engagement sessions, although we will need to produce proposal maps in advance of engagement so that we can gather feedback from residents and businesses.
Phase 3 - Priority parking areas B1, B3, B4, B5, B7 and B10, plus Fettes and Prestonfield
In December 2022, committee agreed to progress Traffic Regulation Order (TRO) proposals for phases 3 and 4. The proposal for phase 3 includes changing the current status of existing Priority Parking Areas (PPAs) in the north and south of the city (B1, B3, B4 and B5) to CPZs and introducing new CPZ controls in the Fettes area. The public consultations on the proposals for the B1, B4 and B5 PPAs, and the Fettes area, ran from 6 June 2025 to 4 July 2025, with consultation on proposals for the B3 PPA and some uncontrolled nearby streets taking place from 1 August to 29 August 2025. For further information, check our live consultations.
The remaining areas of B7, B10 and Prestonfield will be monitored in order to assess the impacts of new parking controls in nearby or neighbouring areas.
Phase 4 - Newhaven, Trinity and Portobello
On 16 December 2025, the Traffic Regulation Orders Sub committee decided against proceeding with the proposed Controlled Parking Zone (CPZ) in Portobello, following members' review of the responses to the advertisement of the related Traffic Regulation Order. You can view the webcast and read minutes, along with the committee report, on the Sub committee's webpage.
Newhaven South and Trinity will be monitored in order to assess the impacts of new parking controls in nearby or neighbouring areas.
Phase 5
In March 2026, the Council’s Traffic Regulation Orders Sub-committee approved the implementation of a Priority Parking Area (PPA) in the Lockharton area, named B11. The new parking controls took effect on 22 June 2026.
The PPA operates from 12.30pm to 2pm, Monday to Friday, and only residents with B11 PPA parking permits, or those with visitor parking permits, are permitted to park during the hours of operation.
Monitoring
We will be monitoring those areas closest to any new CPZ and will carry out surveys before work starts, during implementation, and after the work is complete. These surveys will help us understand whether there has been any migration of parking pressures and what action might be needed.
